BOM Studio · Quality

Real-Time Quality Control: Every Inspection Recorded as It Happens

Quality is not a certificate at the end of the project. In BOM Studio, inspections are built into the production route of every member. A member that is finished is not passed until a QC inspector records the result, a failed inspection stays on the record, and nothing leaves the factory with an open non-conformance.

Tay Ninh, Vietnam Engineering · Fabrication · Shipping Destination: Guyana

Screens

Quality control in BOM Studio

Project QA/QC route with hold points

Inspection steps placed in the production route

For each project, QA/QC sets the inspection steps between production stages: incoming material, fit-up, visual weld inspection, UT / MT, surface preparation, coating thickness and release for shipping.

  • Mandatory, optional or sampling %
  • Hold, witness or review points
  • Standard, measurements and required photographs
Finished is not the same as passed

The Rules

Finished is not the same as passed

When a step with an inspection is finished, the member moves to "Awaiting QC". Only a QC inspector can record PASS or FAIL, and the next stage cannot start beyond the quantity QC has accepted. A failed inspection is recorded with the defect and the action taken, and the re-inspection after repair is recorded as a new inspection (#2, #3), so the history is complete.

The people who report production cannot approve QC, and the people who update erection cannot accept their own work. This separation is built into the permissions, not left to good intentions.

Rules built into the system

  • Hold points stop the next stage until QC accepts the work
  • Each inspection uses a named standard and recorded measurements
  • Failed inspections are kept as evidence, never deleted
  • A waived inspection needs a reason and an approver
  • Members with an open NCR cannot be packed

Performed directly by World Steel

From the shop floor to a released member

Every step is recorded with who, when and what.

  1. 01

    Scan and confirm

    The team scans the member and confirms the finished step.

    Related documents: Production record

  2. 02

    Awaiting QC

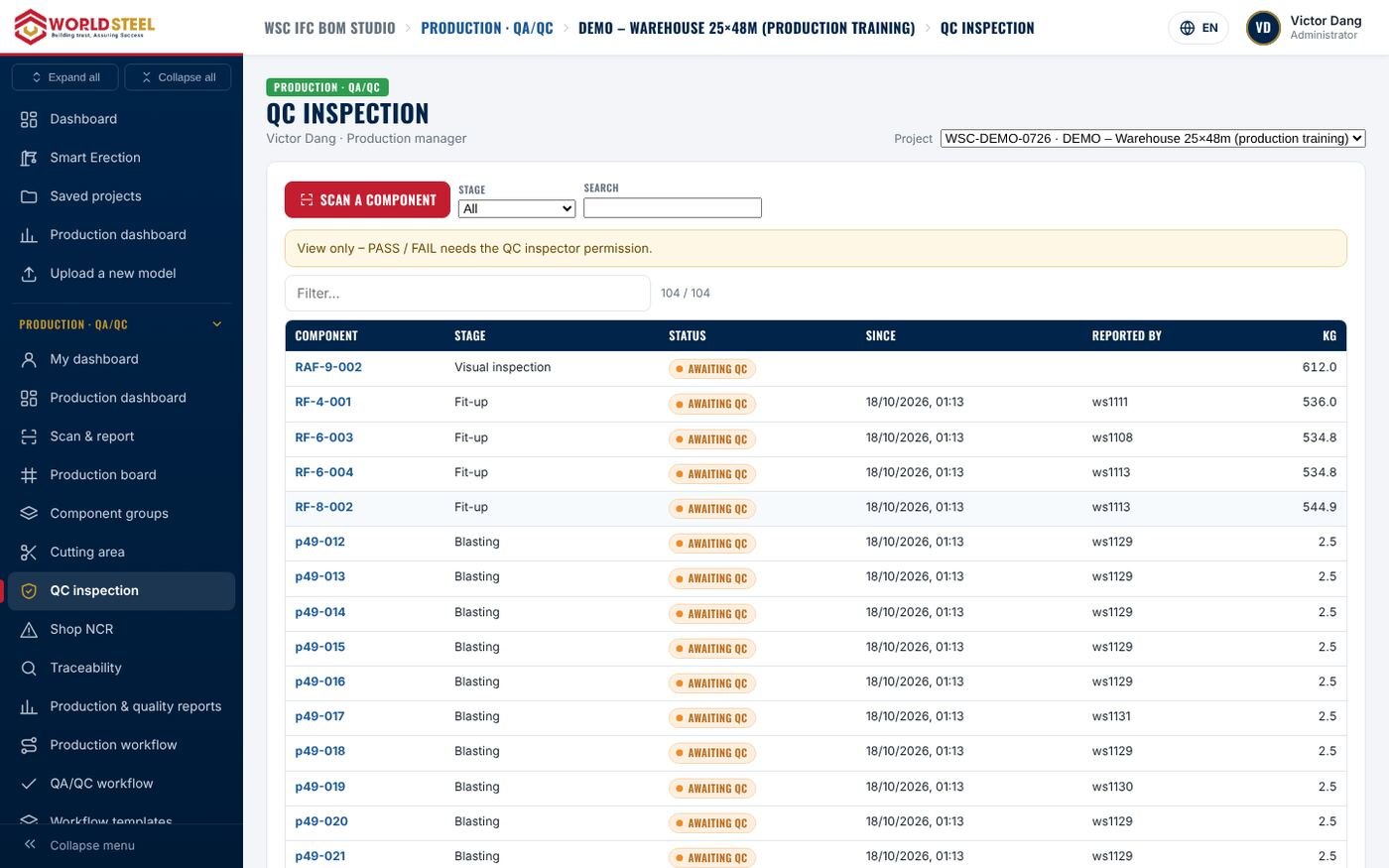

    The member waits in the QC inspector's queue.

    Related documents: Inspection queue

  3. 03

    Inspect

    The inspector checks to the standard in the route, with measurements and photographs where required.

    Related documents: Inspection record

  4. 04

    PASS or FAIL

    PASS releases the member to the next stage. FAIL records the defect and the action: rework, repair, accept with approval or reject.

    Related documents: Result with defect type

  5. 05

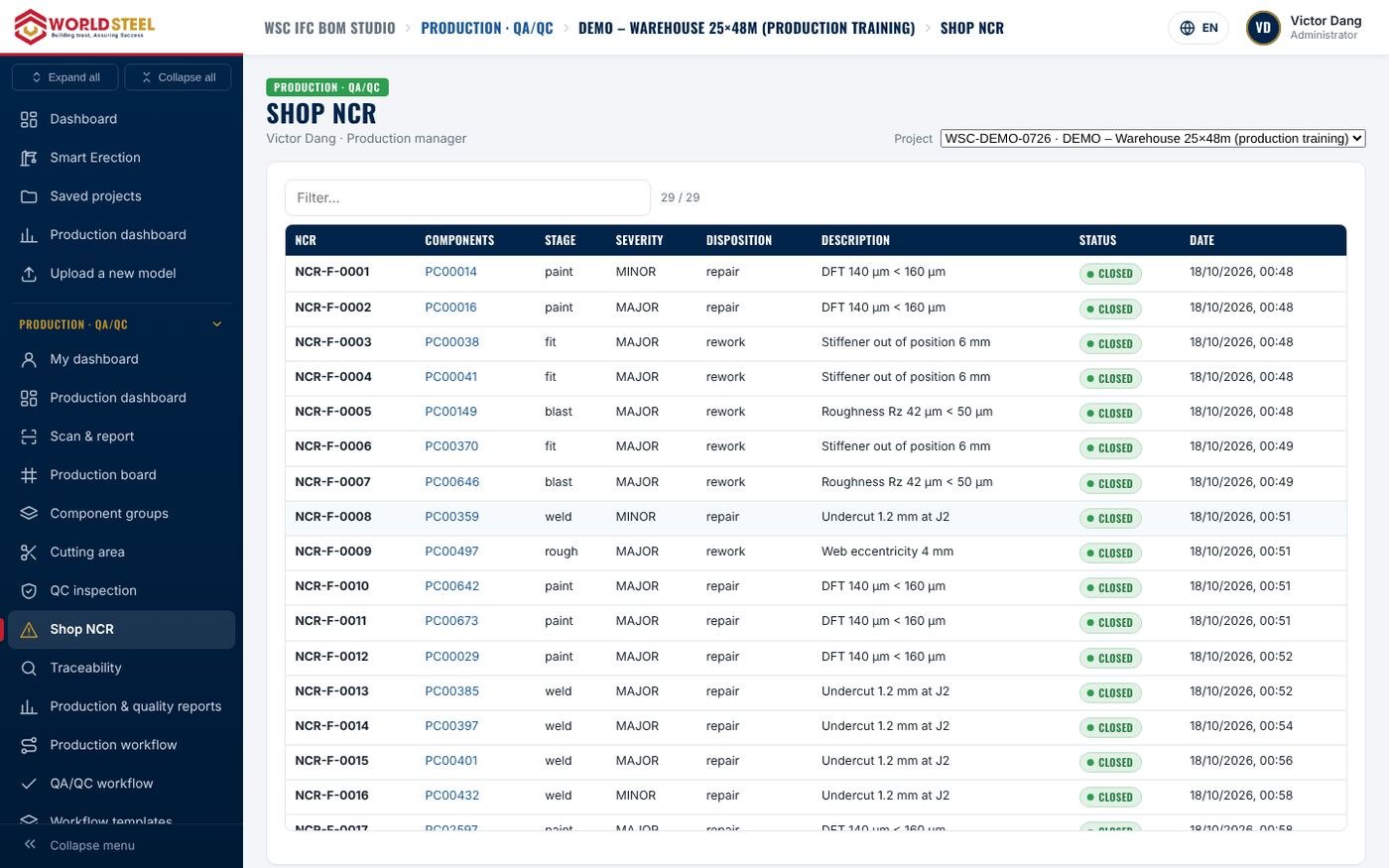

    NCR and re-inspection

    A non-conformance moves from Open to In progress, Awaiting re-inspection and Closed, and only QC can close it. The repaired member is inspected again and the new result is added to its history.

    Related documents: NCR record, inspection #2, #3

  6. 06

    Release

    Only members released by QC, painted and free of open NCRs can be packed for shipping.

    Related documents: Release for packing

Welding

Welding under control

Welding is where traceability matters most. BOM Studio checks it at every scan.

Approved procedures only

Welding procedures (WPS) move from draft to approved to withdrawn. A change creates a new revision; an approved procedure is never edited in place.

Qualified welders only

A welder can only report welding under a procedure they are authorised for. The server rejects a welder whose certificate has expired, whose continuity lapsed for more than six months, or who is outside the qualified range.

Every weld traced

Each weld report records the welder, the procedure and its revision, the data needed for the weld traceability section of your Manufacturer's Data Report.

Expiry warnings

The welding engineer sees certificates that are expired or about to expire before they affect production.

Traceability: answers in seconds

Records are append-only, with the value before and after every change.

QuestionWhere the answer comes from
Who made this member, and when?The member's timeline: every production step, team and date
Which procedure was this weld made to?Weld report: welder, WPS and revision
Which inspection did it pass, and at which attempt?Quality history of the member (PDF): FAIL #1, PASS #2
Which members did this welder work on?Search by welder, team, WPS or date range
Are any members still on hold?QC queue and open NCRs, by project

FAQ

Quality control: questions

Straight answers on scope, design codes, shipping and what happens in Guyana.

Ask an engineer
Can I or my inspector witness inspections?

Yes. Witness points can be set in the QA/QC route for your project, and you can follow the results in BOM Studio. You can also book a live online audit of our factory.

Which standards are used for inspections?

Each inspection step names its standard, for example ISO 5817, AWS D1.1, AS/NZS 1554.1 or EN 1090-2, according to the requirements of your project.

What happens when an inspection fails?

The failure is recorded with the defect and the action taken. The member cannot move on until it is repaired and passes a new inspection, and both results stay in its history.

Can a member with a problem be shipped by mistake?

No. Packing only accepts members that are finished, released by QC, painted and free of open NCRs. The system checks this, not a person with a list.

Do I receive the quality records?

Yes. Inspection records, NCRs and weld traceability are part of the project record and of the handover package.

Discuss the Quality Plan for Your Project

Tell us about your project and its standards. We will show you how inspections and hold points would be set up and reported.

Your details
Project information

We usually respond within two business days (Vietnam time, GMT+7). Your information is never sold or shared for marketing by third parties.

More from BOM Studio

BOM Studio: World Steel Technology

World Steel's own project platform. Every steel member has an ID and QR code, and every step from production to handover is recorded, so you can follow your pr…

Read more

Real-Time Production Reports

Follow the fabrication of your building live: progress by steel weight for every stage, a coloured 3D model, factory photographs and weekly reports from a secu…

Read more

Packing, Containers & Shipping Documents

QR scan packing of QC-released members, checked container load plans, locked packing lists, a QR code on every package and a full report for every container.

Read more

Smart Erection

Traceability that continues on site: component passports by QR code, model navigation, erection sequence, 4D progress, site inspections and an offline site app…

Read more

Digital Handover

A complete, verifiable record of your building, generated from the project data and locked with a SHA-256 manifest.

Read more

Project Risk Control

The risks of an overseas steel project, from model errors to missing members on site, and how BOM Studio controls each one with a check, a rule and a record.

Read more

International Quality Assurance

Traceability, welding control, inspection and test plans, NDT, coating inspection and the quality records you receive with every shipment.

Read more

Export Process & Packing Control

Every member inspected, marked, listed, packed, loaded and photographed: how World Steel makes sure your project in Guyana receives exactly what was designed, …

Read more

Shipping Lines & Transit Times: Vietnam to Guyana

The international shipping lines, routes and transshipment hubs that connect Vietnam with Georgetown, the weekly sailing rhythm, a realistic 45–60 day transit …

Read more
